FF&E Installation

How Many Spares Should an Imported FF&E Package Carry? A Risk-Based Alternative to the 2% Line

By admin10 min read2,079 words

completed restaurant timber screen interior singapore

Almost every imported FF&E order carries a line that reads “2% spares”. It is the least examined number in the package. Two per cent of four hundred wardrobes is eight wardrobes sitting in a warehouse for two years, paying rent, while the item that actually fails in month seven is a discontinued runner nobody ordered a spare of, because a runner is cheap and a wardrobe is expensive and the percentage was applied to value.

A spare parts strategy is not a percentage. It is a short list of components that would be genuinely difficult to obtain later, held in the quantity that covers the realistic failure and damage rate, in the country where they will be needed. Everything else is better dealt with when it happens.

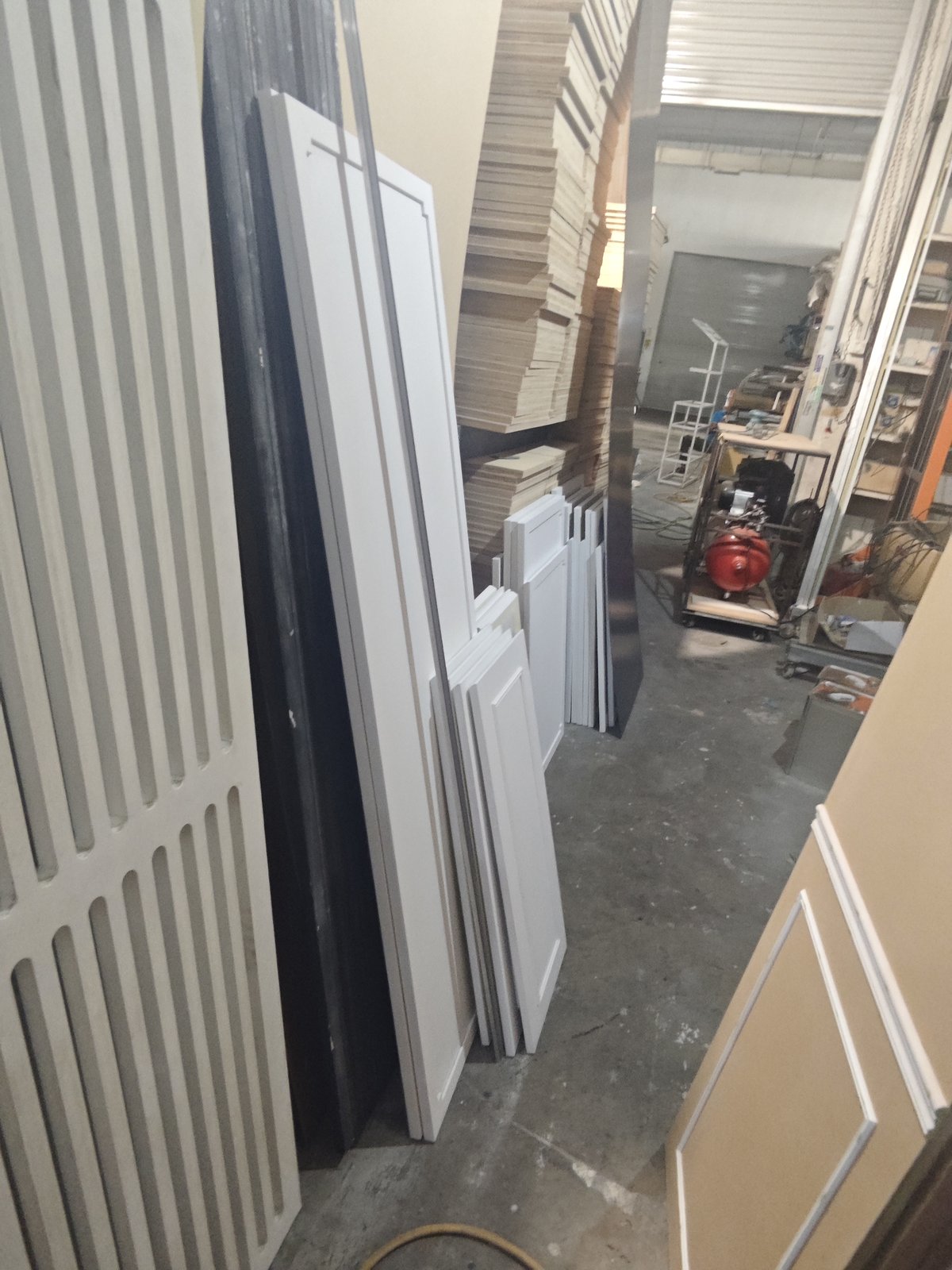

imported furniture components held in local storage singapore
Held stock is only worth its storage cost for components that would be difficult to obtain again. For most items it is cheaper to solve the problem when it appears.

Why a Flat Percentage Is the Wrong Instrument

A percentage treats every component as equally replaceable, which is exactly what they are not. Applied across a package it reliably over-provisions the bulky, generic and easily remade, and under-provisions the small, proprietary and batch-sensitive – because those are cheap, and a percentage of a small number is a smaller number.

What a flat percentage gets wrong:

  • It buys spares of items that could be refabricated locally in days
  • It consumes storage on bulky carcasses that are rarely the thing that fails
  • It under-buys proprietary hardware, where a single obsolete series can strand a whole room type
  • It ignores batch sensitivity, so a colour-matched spare is not actually a match by year two
  • It ignores what the local capability can and cannot resolve
  • It sets a number before anybody has asked which components carry real risk

The alternative is not to order more. On most packages a properly targeted spare list is smaller and cheaper than the percentage it replaces, and materially more useful.

Two Questions Decide the Whole List

For each component type, the provisioning decision collapses into two questions. Nothing else needs to be argued.

1
Can it be reproduced or repaired in Singapore to the approved standard?
If yes, it does not need a spare. A panel that can be refabricated and finished locally in days is not a supply risk.
2
Is it batch-sensitive, proprietary, or long-lead?
If yes, it needs a spare regardless of unit cost – because the constraint is availability, not price.

Almost every component falls cleanly into one of four boxes on those two axes, and only one of the four justifies held stock: the things that cannot be made here and cannot be reordered quickly.

Worth holding locally:

  • Project-specific hardware – hinges, runners, locks, catches and handles in the exact series and finish
  • Proprietary connectors and fixings the assembly depends on
  • Batch-matched finish materials – laminate, veneer leaves, edge banding from the approved lot
  • Feature or decorative components that cannot be remade locally to standard
  • Glass and mirror to the specified specification and edge treatment, where lead time is long
  • Stone offcuts from the installed slab, kept for local repair and colour matching
  • Small quantities of the approved paint or lacquer, with the batch reference recorded

Not usually worth holding:

  • Complete bulky items – full wardrobes, vanities, counters, bed frames
  • Generic carcass board that is locally available in the same specification
  • Standard skirtings, fillers and trims that are fabricated locally anyway
  • Generic hardware still current and stocked by local distributors
  • Anything a competent local workshop can refabricate and finish within the acceptable window
glazed display cabinet run with concealed hardware singapore
A completed run. The hinges, runners and catches inside it are the components most likely to wear out first and the hardest to match two years later.

Batch Sensitivity Is the Real Driver

The argument for holding spares is usually made in terms of lead time, but the harder problem is matching. Many finishes are produced in batches, and a batch is not an exact repeat of the one before it – laminate and paint drift in shade and sheen, veneer varies in grain and colour within a species, metal finishes drift more than most specifiers expect, and stone from a different block is a different stone.

So a spare ordered two years later against the same product code can arrive correct on paper and visibly wrong in the room. A spare taken from the original production run cannot. That is the whole case for batch-matched stock, and it applies to the material more than to the finished component.

Record this against every held spare, or it stops being useful:

  • Batch or lot number, and the production date
  • The exact product code and supplier, including finish and sheen designation
  • Which room types and item references it belongs to
  • The approved sample reference it was matched against
  • Storage conditions required, particularly for timber, veneer and adhesives
  • Quantity held, and where

Held stock with no record attached is difficult to use with confidence three years in. The schedules that make this work are the same ones that should ship with the goods – see our guide to installation-ready packing and documentation.

The Defect Route Decides the Spare List

Spares only make sense once the project has decided how defects will actually be resolved. If the agreed route for a scratched painted door is local refinishing, a spare door is dead stock. If the agreed route is replacement because the finish cannot be matched on site, it is essential.

1
Adjust in place
Alignment, hardware and fixing adjustments. No spare needed, and this covers the majority of reported items.
2
Modify or repair locally
Trimming, filler adjustment, local cut-outs, component repair. Needs capability and material, not held stock.
3
Refinish locally
Touch-up, panel refinishing or full respray. Needs the batch-matched coating and a retained reference, not a spare panel.
4
Replace from local spare stock
The route that justifies held stock – proprietary hardware, batch-matched components, long-lead items.
5
Remanufacture overseas
What is left. Every item you can move out of this row is weeks off a rectification, and a shorter spare list.

Deciding these routes before handover rather than at the first defect is what stops each item becoming a fresh negotiation. Our guides to replacement parts and local rectification and spray-paint rectification cover what each route can realistically resolve.

Where Spares Live, and Who Owns Them

A spare in a factory warehouse in China is not a spare; it is an order with a head start. For it to shorten a rectification it has to be in Singapore, findable, and released by somebody without a procurement cycle.

Settle these when the spares are ordered, not when they are needed:

  • Who stores them, at whose cost, and for how long
  • Whether title sits with the developer, the main contractor or the supplier
  • Who is authorised to draw stock, and what record that creates
  • Whether consumption is replenished, and at whose cost
  • What happens to the remainder at the end of the liability period
  • Environmental conditions – painted panels and veneer will not survive an unconditioned store
  • How stock is inventoried against the FF&E schedule so it can actually be located

The last point is the one that quietly defeats most spare programmes. Stock that exists but cannot be identified against a room type and item reference gets treated as if it does not exist. The referencing convention is the same one used for handover records – see our guide to asset tagging and room-by-room handover records.

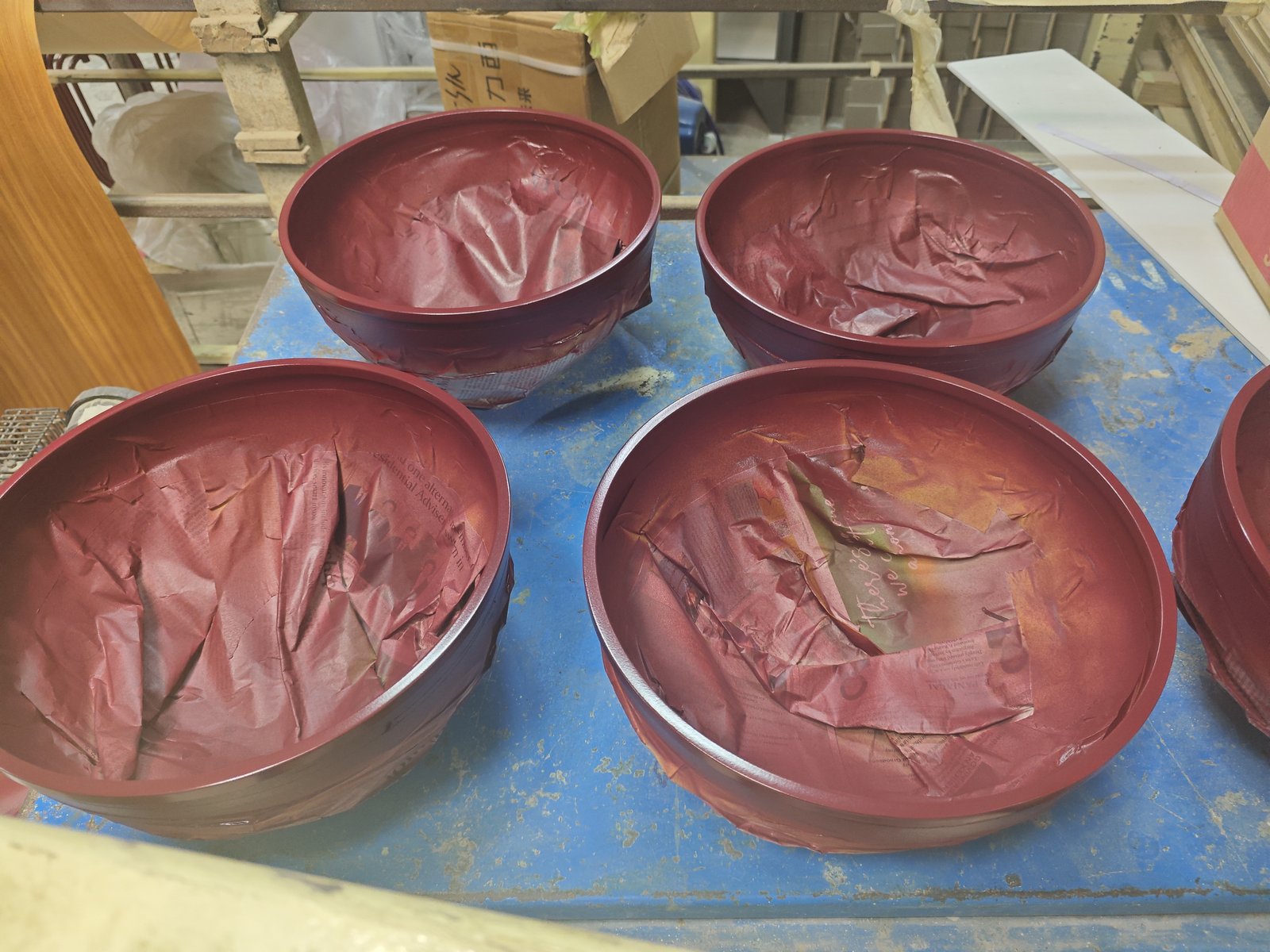

lacquer colour mixing against approved batch reference singapore
Coating mixed against a recorded batch. Holding the material with its lot reference is worth more than holding a finished spare panel.

How Much, Concretely

Quantities should follow the realistic failure and damage rate of that component over the liability period, not a percentage of the package. The useful reference points are mundane.

Reasonable provisioning logic:

  • Moving hardware – size against the number of installed cycles, not the number of units; a hinge on a heavily used door is a wear item
  • Batch-matched finish material – hold enough to refinish a realistic number of panels, in sheet or litre terms rather than component terms
  • Proprietary connectors – a generous count, because they are small, cheap and project-stopping
  • Feature components – one of each type where it cannot be remade locally, none where it can
  • Glass and mirror – size against breakage risk and lead time, which on some specifications is months
  • Stone – retain offcuts rather than ordering spare slabs

On most packages this produces a list of perhaps fifteen to thirty line items, mostly small, at a fraction of the cost and storage footprint of a blanket percentage.

What to Specify at Order Stage

Spares are cheapest to secure while the production run is still open. Once the line has moved on, a batch-matched spare stops being available at any price.

Include in the purchase specification:

  • The spare schedule itself, by item reference rather than as a percentage
  • That finish-critical spares are taken from the same production batch as the installed goods
  • That batch and lot references are recorded and shipped with the spares
  • That spares are packed and labelled separately, to the same room and item convention
  • Where they are to be delivered – the Singapore store, not the site
  • Which items the factory will continue to supply, and for how long after handover
  • Notification obligations if a hardware series or finish is discontinued

The last item is worth insisting on. A discontinued hinge series is the most common way a perfectly maintainable package becomes unmaintainable, and the factory usually knows months before the project does.

How Rongda Pacific Handles Spares

Rongda Pacific Pte Ltd is generally the party holding and drawing on this stock, because we are the party attending when something has to be rectified. In practice that means helping build the spare schedule against what can and cannot be resolved locally, receiving and inventorying the spares against the FF&E references, storing finish-sensitive items in appropriate conditions, drawing and recording consumption during installation and the liability period, and telling the project when a held item has been used up and matters.

The test of a spare programme is not whether stock exists. It is whether the person standing in the room with a defect can have the right component in their hand the same week.

Frequently Asked Questions

Is 2% spares a reasonable starting point?

Not really, because it allocates by value rather than by risk. It over-provisions bulky generic items that could be remade locally and under-provisions small proprietary hardware, which is where the actual supply risk sits. A targeted schedule is usually smaller, cheaper and more useful.

Which components genuinely need spares?

The ones that cannot be reproduced locally to the approved standard and cannot be reordered quickly: project-specific hardware, proprietary connectors, batch-matched finish materials, long-lead glass, and feature components that cannot be remade here.

Why does the production batch matter for a spare?

Because finishes drift between batches. Laminate and paint move in shade and sheen, veneer varies within a species, and metal finishes drift more than expected. A spare ordered later against the same code can be correct on paper and visibly wrong in the room.

Should spares be held in Singapore or at the factory?

In Singapore. A spare held overseas is an order with a head start, not a spare – it still carries shipping, customs and handling before it reaches the room.

What about complete items – spare wardrobes or vanities?

Rarely worth it. They consume most of the storage budget, are seldom the thing that fails, and are usually the category a competent local workshop can refabricate. Hold the components, not the assemblies.

How long should spares be kept?

Normally through the defects liability period at minimum, with a decision at the end about what transfers to the operator or managing agent for ongoing maintenance. That decision is far easier if it was agreed when the spares were ordered.

What makes held stock unusable?

Missing records and unsuitable storage. Stock that cannot be identified against a room type and item reference gets treated as though it does not exist, and painted or veneered panels held in an unconditioned store will no longer match.

Can a spare strategy reduce the defect list?

It shortens closure rather than reducing the count. Items that would otherwise wait on an overseas remanufacture close within the week instead, which is what keeps a defect list shrinking during handover rather than growing.

Specifying spares for an imported FF&E package and want the schedule built against what can actually be resolved in Singapore? Send us your enquiry, message us on WhatsApp at +65 8897 3670 or email [email protected].

More in FF&E Installation

Scroll to Top
WhatsApp us
